Hickory Creek Road Phase 3 Project
The Hickory Creek Road Phase 3 project is located on Hickory Creek Road from Riverpass Drive to FM-1830. To improve safety and mobility in the area, the project includes the design and construction of a four-lane extension and realignment of Hickory Creek Road from Riverpass Drive to FM-1830, and the construction of a bridge that will span Hickory Creek and remove the safety concern of the 90 degree curve from the current Hickory Creek alignment. This project is part of a larger reconstruction and widening project for Hickory Creek Road with the goal of a continuous four lane divided roadContinue reading
The Hickory Creek Road Phase 3 project is located on Hickory Creek Road from Riverpass Drive to FM-1830. To improve safety and mobility in the area, the project includes the design and construction of a four-lane extension and realignment of Hickory Creek Road from Riverpass Drive to FM-1830, and the construction of a bridge that will span Hickory Creek and remove the safety concern of the 90 degree curve from the current Hickory Creek alignment. This project is part of a larger reconstruction and widening project for Hickory Creek Road with the goal of a continuous four lane divided road along Hickory Creek Road from FM 2499 to FM 1830.
Project Status

-
April 2025 Project Update
Share April 2025 Project Update on Facebook Share April 2025 Project Update on Twitter Share April 2025 Project Update on Linkedin Email April 2025 Project Update linkI didn't get to have children of my own but from what I've heard - there is an incredible excitement, then a fear, and excitement, and some chaos and pain, frustration all for the joy waiting for a baby. FOR ME - I have a similar emotional experience to my projects. I'm Tracy L. Beck (PE, PMP, PMI-CP blah blah blah) and I'm so excited to be your Hickory Creek Road Phase 3 Project Manager!
Keeping with the graphic birthing analogy - because I know the Hickory Creek Road Community is nothing short of tough, patient, and frustrated! I know you've been pushing and screaming and wondering when this project will take off.... when will the Water Break? When will the contractor be back to Break Ground? It's NOW!
WORK ACTIVITIES

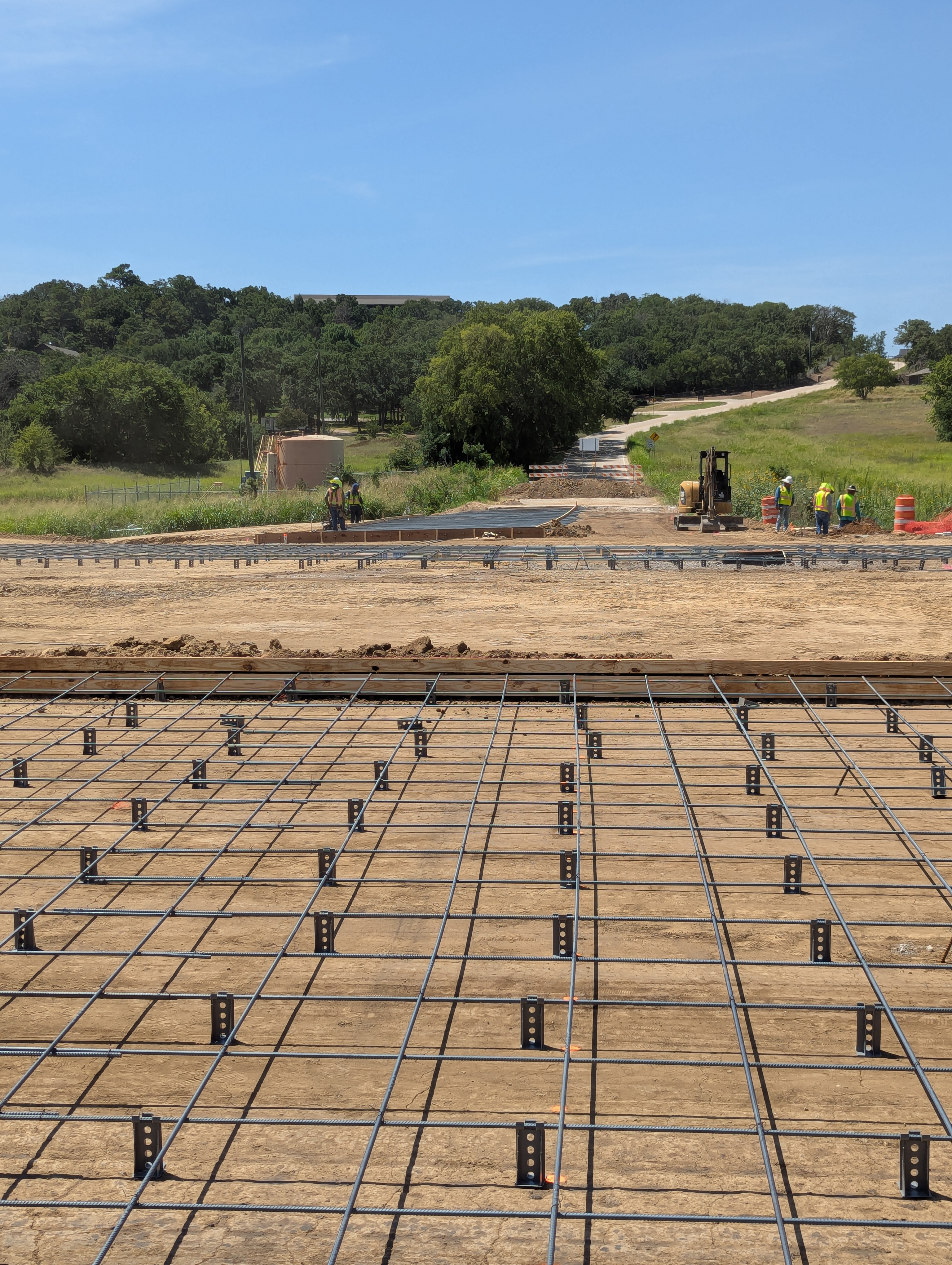

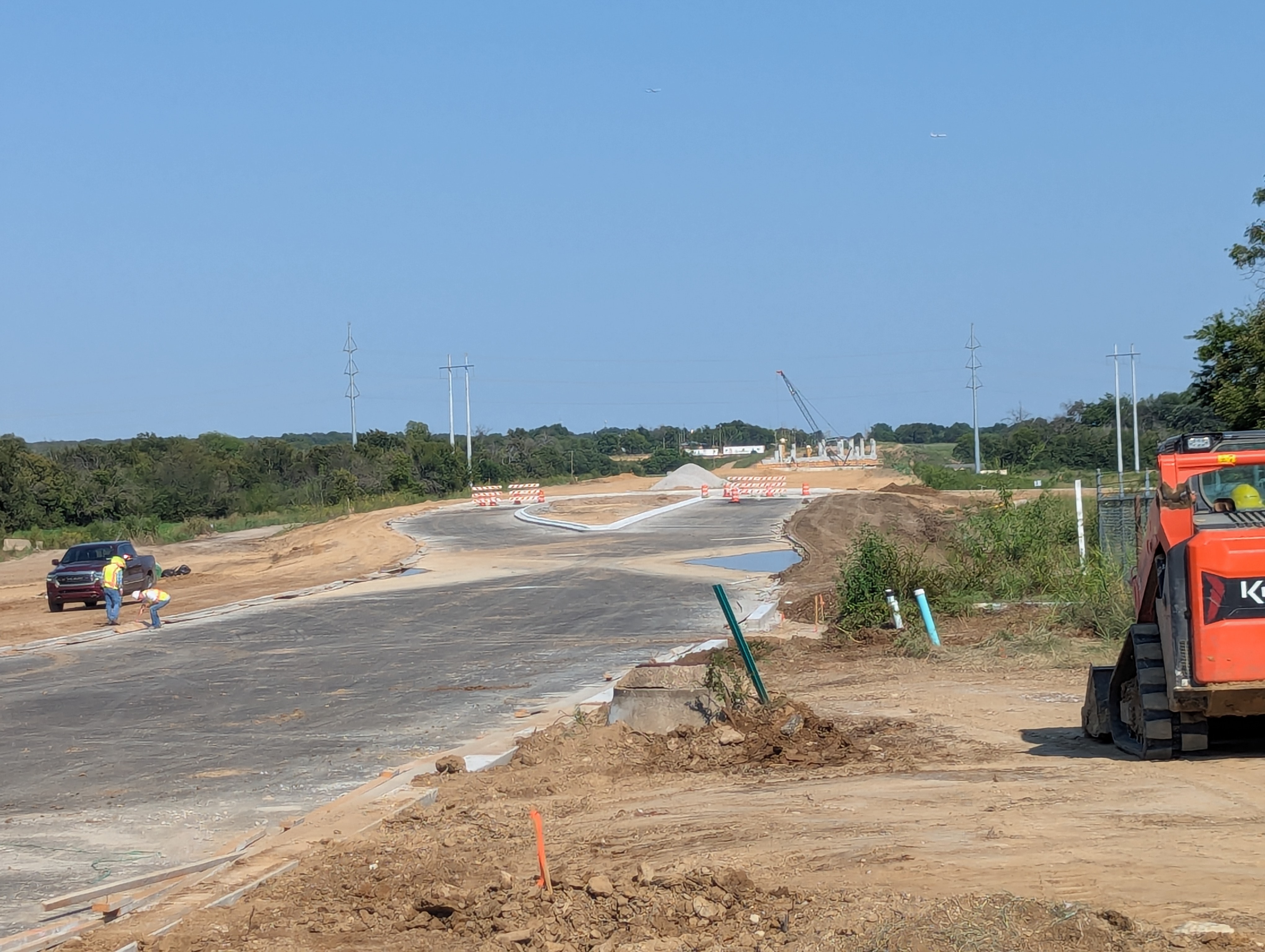

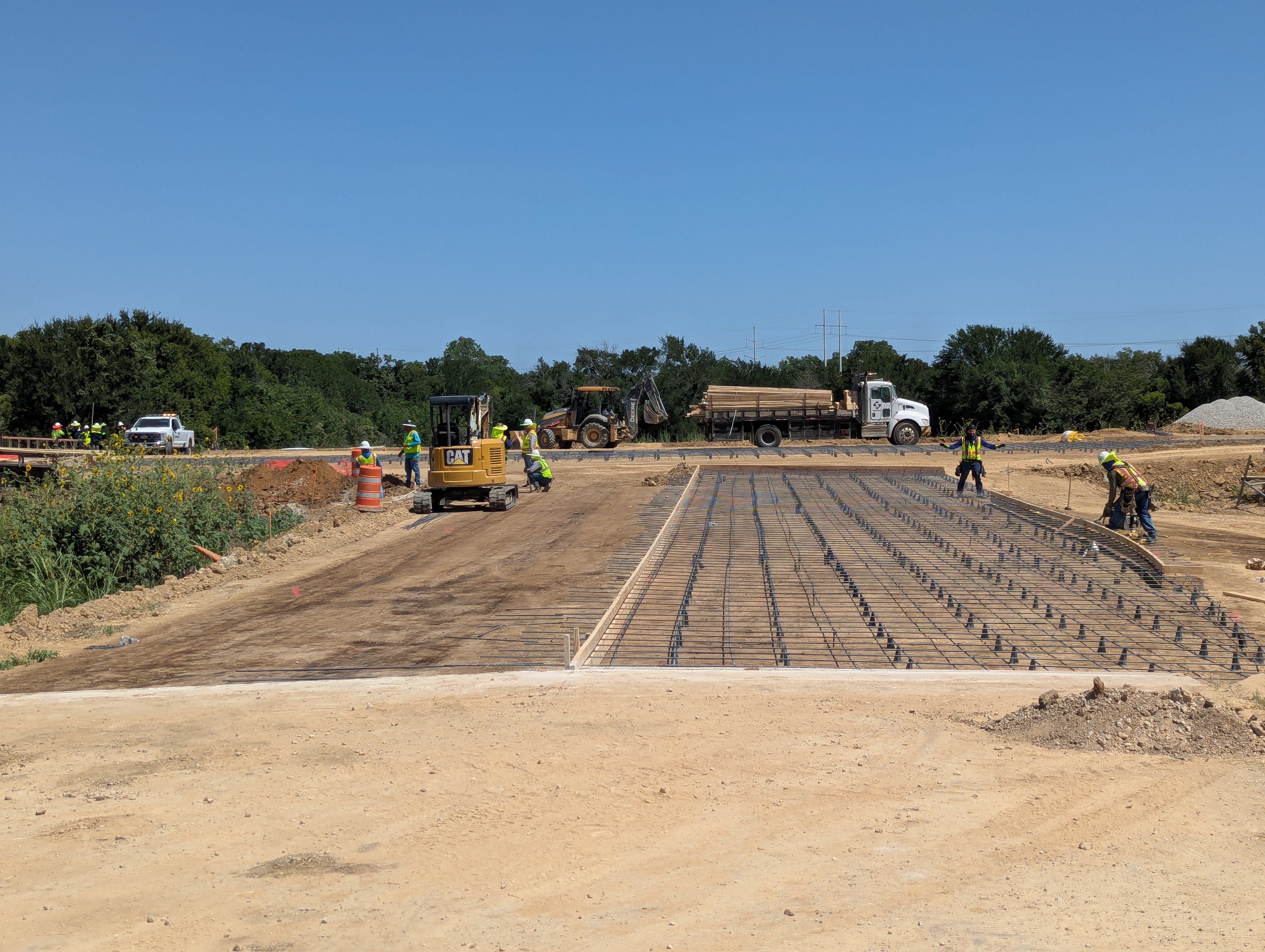

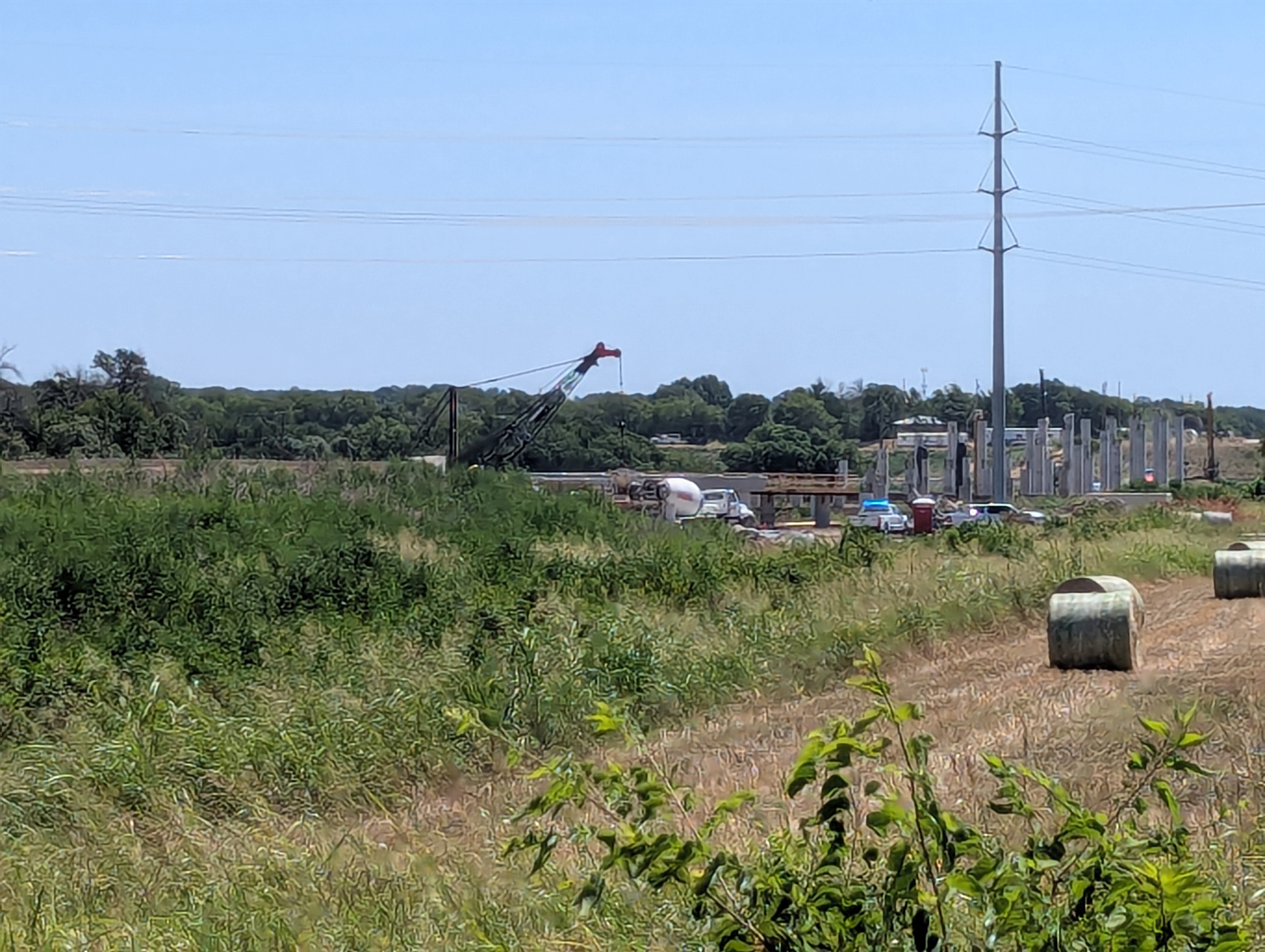

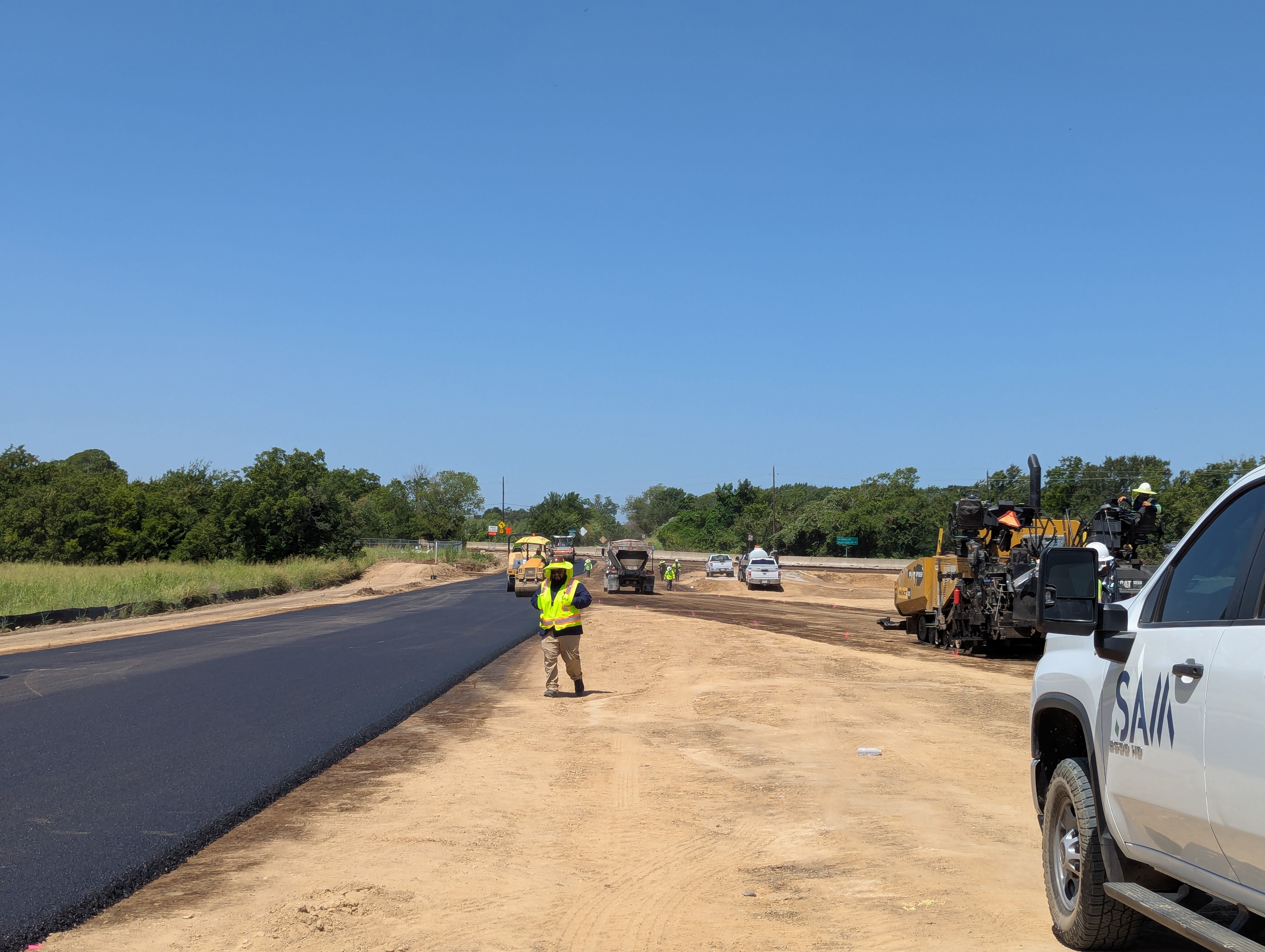

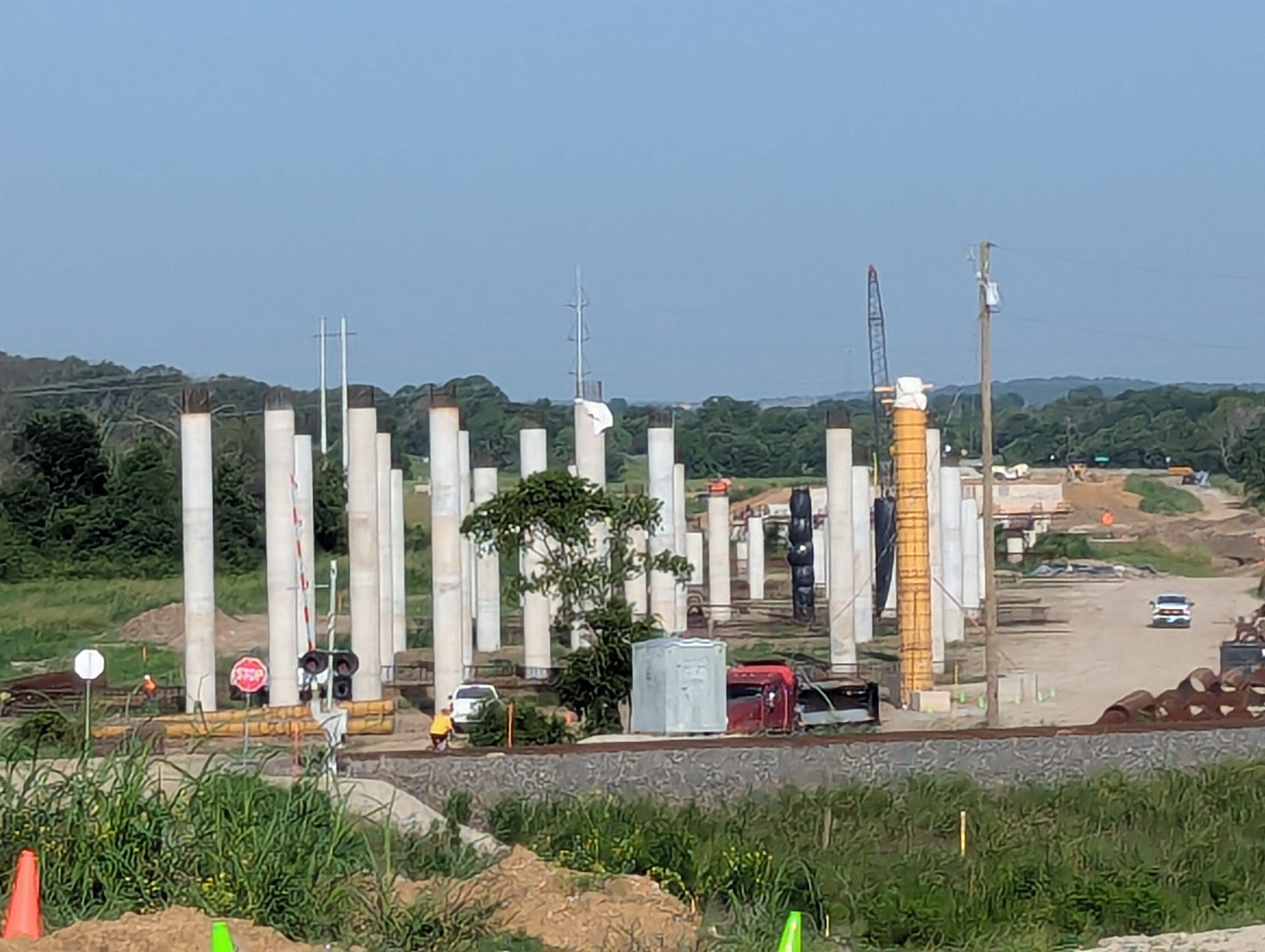

Yes - It's time!!!! Mario Sinacola is on their way back. You're going to see them re-mobilizing and getting ready to start full construction in May. Specifically, what you are seeing this week and next:
- House Keeping
- General Set Up - Moving in Field Offices
- Assessing right of way/Site Preparation
- Coordinating Environmental/Watershed efforts
- Working on the eastern embankment
As always - please stay tuned to this website page for updates and future construction progress in the coming days. For those with more questions - you are welcome to use the Ask the Project Team link in this webpage or if easier - please don't hesitate to contact me directly at Tracy.Beck@CityofDenton.com
- House Keeping
-
They are on their way!!
Share They are on their way!! on Facebook Share They are on their way!! on Twitter Share They are on their way!! on Linkedin Email They are on their way!! link -
that's right.....
Share that's right..... on Facebook Share that's right..... on Twitter Share that's right..... on Linkedin Email that's right..... link -
Shhhhhhh.....
Share Shhhhhhh..... on Facebook Share Shhhhhhh..... on Twitter Share Shhhhhhh..... on Linkedin Email Shhhhhhh..... link -
March 2025 Project Update
Share March 2025 Project Update on Facebook Share March 2025 Project Update on Twitter Share March 2025 Project Update on Linkedin Email March 2025 Project Update link
Happy St. Patrick's Day - The City has continued to make progress on getting the Hickory Creek Road Phase 3 project back into construction. We sincerely appreciate your patience, and questions. This project is extremely important to the City and will offer such a great benefits and traffic relief when complete. As of today, we are continuing to work with the contractor on an exact date for starting work. The target has been 1st Quarter 2025 and that still may happen but construction most likely won't kick off until April 2025. Construction will take approximately 18 months once started. The following successes over the past couple of weeks include several hurdles to the project's timeline:- 3/14/25 Gas foam line Utility conflict cleared.
- 3/5/25 TxDOT Approved work in TxDOT right of way for new road tie-in and new northbound right turn lane from Country Club/FM 1830 to new Hickory Creek Road
- 3/3/25 Railroad agreement executed. I cannot tell you how significant this accomplishment has been. Coordination with the Railroad started years ago. In fact, the plans were submitted to the railroad 8/24/2021 and approved 2/4/2022. The agreement was almost approved in 2023 but the KCS and CP railroads merged and EVERYTHING that was coordinated needed to start from scratch with the newly formed CPKC railroad. Council approved the agreement 12/17/2024 and, as noted, the Railroad just approved the agreement on Monday March 3, 2025.
- Underway - Atmos Gas - New Line is in construction (not part of Hickory Creek Road Project but coordinated).
Please stay tuned to this page for updates on the start date and future construction progress. For those with more questions - you are welcome to use the Ask the Project Team in this webpage or if easier - please don't hesitate to contact me directly at Tracy.Beck@CityofDenton.com
-
January 2025 Project Update
Share January 2025 Project Update on Facebook Share January 2025 Project Update on Twitter Share January 2025 Project Update on Linkedin Email January 2025 Project Update linkQuick update - The City is working with the contractor to determine an exact date when Phase 3 of the Hickory Creek Road/Bridge project will resume. The City has made significant progress including coordination with the CPKC Railroad, Oncor Electric, Atmos Gas, and the new Parkside development. Please stay tuned to this page for updates on the start date and future construction progress.
-
November 2024 Project Update
Share November 2024 Project Update on Facebook Share November 2024 Project Update on Twitter Share November 2024 Project Update on Linkedin Email November 2024 Project Update linkQUICK update - We don't have an exact date when we will RESTART Hickory Creek Road/Bridge Phase 3 but we are continually making progress on the remaining items. For example - you may have noticed work in the area (such as new and removed utility poles). You will also see Atmos gas coming thru with a new line on the east side of the new bridge. Although the new road/bridge work won't be able to start by the close of this year, it's promising to kick off in the early new year. Stay tuned to this page for updates on the actual start date as well as ongoing updates through construction.
-
September Project Update
Share September Project Update on Facebook Share September Project Update on Twitter Share September Project Update on Linkedin Email September Project Update linkThank you all
for your patience! I'm the new Project Manager as of August and I know you have been waiting for this project to start and I know it's been a challenge for you. We are actively working behind the scenes to start the project back up. No one intended for this delay. Contractors and Inspectors are happiest in the field and I LOVE getting projects across the finish line. Stay tuned for updates. We're trying get started as soon as possible.
Tracy
-
August Project Update
Share August Project Update on Facebook Share August Project Update on Twitter Share August Project Update on Linkedin Email August Project Update linkThe Hickory Creek Road Phase 3 project is currently experiencing a delay in construction due to rail road coordination and the ONCOR distribution line relocation. ONCOR crews have began pole installation and are project to finish this month. City of Denton staff is also coordinating with the railroad to get all railroad requirements required to get the project back going. The current estimated completion for the project is projected for Q4 2026, but we anticipate the bridge to be open in late 2025. Please use caution and observe all work zone signs while in the Hickory Creek RD area. The project has a new City of Denton Project Manager that will be taking the project over moving forward. Her name is Tracy Beck, and if you have any questions or concerns please contact her at Tracy.Beck@cityofdenton.com or by using the ask a project manager link on the Discuss Denton project page.
-
July Project Update
Share July Project Update on Facebook Share July Project Update on Twitter Share July Project Update on Linkedin Email July Project Update linkThe Hickory Creek Road Phase 3 project is currently experiencing a delay in construction due to rail road coordination and the ONCOR distribution line relocation. ONCOR crews have began project staking and are ready to mobilize in the next two weeks pending no major weather delays. City of Denton staff is also coordinating with the railroad to get all railroad requirements required to get the project back going. Please use caution and observe all work zone signs while in the Hickory Creek RD area. If you have any questions or concerns please contact me at Dustin.Draper@cityofdenton.com or by using the ask a project manager link on the Discuss Denton project page.
Stay Updated and Have Your Say
Click HERE to register to stay informed and ask the project manager a question about the Hickory Creek Road Phase 3 Capital Improvement Project.
Project Information
Budget: $54 Million
Sponsoring Division: Engineering Department
Funding Source: 2019 Bond Program
Project Location: Riverpass Drive to FM 1830
Contact Information:
Multi-phase projects may require different project managers. Below is the current project manager(s) and the phase(s) they manage.
Who's Listening
-
Phone (940) 349-8925 Email tracy.beck@cityofdenton.com -
Senior Project Manager
