Bonnie Brae Street
To accommodate mobility needs, Bonnie Brae Street is being expanded from a two-lane undivided rural roadway to a four-lane divided urban street. This six-phase project has three phases completed (1,2 & 4A), Phase 3 is currently in construction. Below are the project limits and status for each phase.
PROJECT PHASES & STATUS
Phase 1 (Roselawn to North of Vintage Boulevard) - COMPLETE
Phase 2 (I-35W TO US 377 Includes Vintage Blvd) - COMPLETE
Phase 3 (Roselawn to IH-35E) IN CONSTRUCTION | Project Timeline: 2023 - 2026
Sundt Construction was issued a Notice to Proceed on October 16, 2023. The projectContinue reading
To accommodate mobility needs, Bonnie Brae Street is being expanded from a two-lane undivided rural roadway to a four-lane divided urban street. This six-phase project has three phases completed (1,2 & 4A), Phase 3 is currently in construction. Below are the project limits and status for each phase.
PROJECT PHASES & STATUS
Phase 1 (Roselawn to North of Vintage Boulevard) - COMPLETE
Phase 2 (I-35W TO US 377 Includes Vintage Blvd) - COMPLETE
Phase 3 (Roselawn to IH-35E) IN CONSTRUCTION | Project Timeline: 2023 - 2026
Sundt Construction was issued a Notice to Proceed on October 16, 2023. The project is expected to be complete in November 2026 (weather permitting).
Any full or partial lane closures lasting longer than 2 days will be updated on the city street closure report: Weekly Street Closure Report. Message Boards will be updated with any closures and detours will be posted accordingly.
A virtual community meeting was held on Wednesday September 20, 2023, at 6pm. You can view the presentation in the Community Updates tool on your right. Look for any specific updates below...
Phase 4A (Roundabout at Scripture | Project Timeline: 2019 - 2020 - COMPLETE
Phase 4B (I-35E Service Road to Roundabout at Scripture) | Project Timeline: TBD
Phase 5 (Roundabout at Scripture to US380) | Project Timeline: TBD
Recently, this section of roadway was re-paved as part of the North South Water Phase 3, 42-inch Water Transmission Main project. Phases 4B & 5 of the Bonnie Brae Roadway Project will provide a 4-lane divided roadway with a raised median and tie into the US380-University Drive Intersection matching the Bonnie Brae Phase 6 alignment.
Phase 6 (US380 to US77) IN CONSTRUCTION | Project Construction Timeline: 2025 - 2027
Project phases are listed for active and/or planned projects. These phases reflect the range of a project life cycle from project initiation to project completion & close-out. The year range reflected is for the estimated construction timeline only. These estimated construction timelines may change due to weather, contractor scheduling, material delays, and/or other factors. Timelines will be updated when needed. All Bonnie Brae Phases are shown, including COMPLETED Phases in an effort to show the entire Bonnie Brae Corridor.
-
PHASE 3 (FM1515/Airport Rd to Roselawn) FULL ROAD CLOSURE: AIRPORT ROAD, BONNIE BRAE at 35E - 7.30 through 8.18.2025
Share PHASE 3 (FM1515/Airport Rd to Roselawn) FULL ROAD CLOSURE: AIRPORT ROAD, BONNIE BRAE at 35E - 7.30 through 8.18.2025 on Facebook Share PHASE 3 (FM1515/Airport Rd to Roselawn) FULL ROAD CLOSURE: AIRPORT ROAD, BONNIE BRAE at 35E - 7.30 through 8.18.2025 on Twitter Share PHASE 3 (FM1515/Airport Rd to Roselawn) FULL ROAD CLOSURE: AIRPORT ROAD, BONNIE BRAE at 35E - 7.30 through 8.18.2025 on Linkedin Email PHASE 3 (FM1515/Airport Rd to Roselawn) FULL ROAD CLOSURE: AIRPORT ROAD, BONNIE BRAE at 35E - 7.30 through 8.18.2025 linkOn Wednesday July 23rd, TxDOT advised they would be closing South Bonnie Brae from Airport Road to I35E for their contractor (SEMA) to complete the state’s portion of Bonnie Brae and the Service Road. This would mean trucks coming off Airport Road would have no choice but to turn right and head south on Bonnie Brae to either Willowwood or Roselawn (Parvin is currently closed).
In an attempt to prevent heavy truck traffic through residential neighborhoods and confusion on the closure, staff determined it best to close Airport Road and detour traffic to Western Blvd., as it is a familiar route.
Starting Wednesday July 30, 2025, Airport Road will be closed between the I35E Frontage Road and Airport/I35W Frontage Road. Anticipated duration of closure will be nineteen (19) days, weather permitting. Upon construction completion Airport Road/FM1515 and Bonnie Brae at 35E will re-open to traffic. (August 18, 2025)
Detour signs will be posted providing alternate routes and directing traffic around closure. All message boards will be updated to reflect closure dates.
-

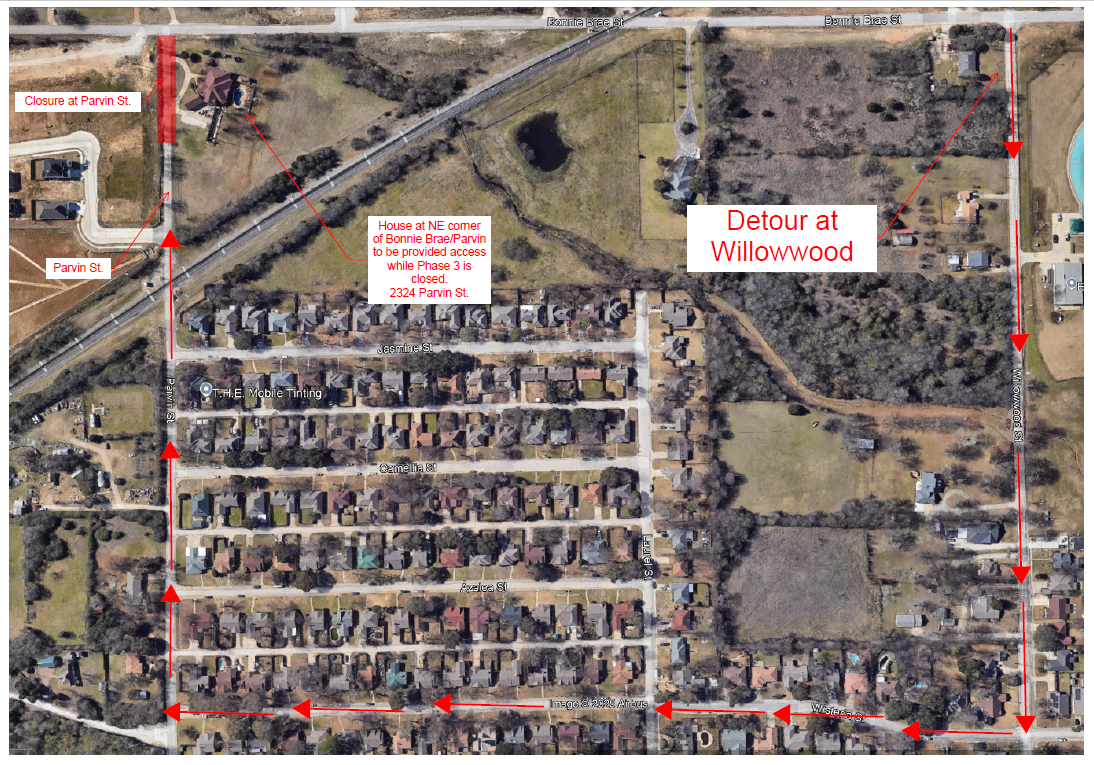

PHASE 3 (Airport Rd/FM 1515 to Roselawn) PARVIN ROAD CLOSED 7.21 - 9.5.2025
Share PHASE 3 (Airport Rd/FM 1515 to Roselawn) PARVIN ROAD CLOSED 7.21 - 9.5.2025 on Facebook Share PHASE 3 (Airport Rd/FM 1515 to Roselawn) PARVIN ROAD CLOSED 7.21 - 9.5.2025 on Twitter Share PHASE 3 (Airport Rd/FM 1515 to Roselawn) PARVIN ROAD CLOSED 7.21 - 9.5.2025 on Linkedin Email PHASE 3 (Airport Rd/FM 1515 to Roselawn) PARVIN ROAD CLOSED 7.21 - 9.5.2025 linkParvin Road between Larkhall Lane and Bonnie Brae will be closed on Monday July, 21st to install the drainage infrastructure crossing under Parvin and complete paving improvements of Parvin as it relates to Bonnie Brae Phase 3.
Weather permitting, Parvin will re-open to traffic by the end of day, Friday September, 5th.
There will be no access to Parvin from Bonnie Brae during this closure. Access to Bonnie Brae will be from either Willowwood, Roselawn or Airport Rd.
Please follow posted detour signs.
We appreciate your patience as we work to complete these much needed improvements.
-
Phase 6 - Contractor continues to work on concrete pavement detour.
Share Phase 6 - Contractor continues to work on concrete pavement detour. on Facebook Share Phase 6 - Contractor continues to work on concrete pavement detour. on Twitter Share Phase 6 - Contractor continues to work on concrete pavement detour. on Linkedin Email Phase 6 - Contractor continues to work on concrete pavement detour. linkContractor continues to work on concrete pavement detour at the intersection of Bonnie Brae and Riney Road. After traffic is moved over to the detour the Contractor will start working on constructing the new street intersection.
-
Phase 6 - Contractor continues to install 16-inch ductile iron pipe along Bonnie Brae
Share Phase 6 - Contractor continues to install 16-inch ductile iron pipe along Bonnie Brae on Facebook Share Phase 6 - Contractor continues to install 16-inch ductile iron pipe along Bonnie Brae on Twitter Share Phase 6 - Contractor continues to install 16-inch ductile iron pipe along Bonnie Brae on Linkedin Email Phase 6 - Contractor continues to install 16-inch ductile iron pipe along Bonnie Brae linkThe Contractor continues to install the 16-inch ductile iron pipe along Bonnie Brae from Riney Road to Windsor Drive.
-
Phase 6 - Installation of 12-inch waterline for Reeves Elementary School
Share Phase 6 - Installation of 12-inch waterline for Reeves Elementary School on Facebook Share Phase 6 - Installation of 12-inch waterline for Reeves Elementary School on Twitter Share Phase 6 - Installation of 12-inch waterline for Reeves Elementary School on Linkedin Email Phase 6 - Installation of 12-inch waterline for Reeves Elementary School linkTiseo Paving Company is installing a 12-inch waterline where the Contractor building Reeves Elementary School will tie-in for their water supply.
-
PHASE 3 - FM1515/Airport Road to Roselawn
Share PHASE 3 - FM1515/Airport Road to Roselawn on Facebook Share PHASE 3 - FM1515/Airport Road to Roselawn on Twitter Share PHASE 3 - FM1515/Airport Road to Roselawn on Linkedin Email PHASE 3 - FM1515/Airport Road to Roselawn linkPhase 3 is progressing with installation of the new water and sanitary sewer systems as well as new underground drainage infrastructure at both the north and south ends of the project. On January 27th, Bonnie Brae at Airport Road was fully closed to all traffic. The contractor is working to complete all the underground improvements as well as paving of the section of Bonnie Brae between Airport Road and Main Stadium Drive to ensure this section of roadway can be open and accept traffic from TxDOT's 35E-Merge project which is now also under construction. Weather permitting, paving activities in this section will be complete and re-open to traffic in mid June 2025.
Paving has begun on the south end of the project near Roselawn. Sections of both the north and south bound lanes have been installed between Erskine and Roselawn.
Ongoing spot road closures through-out south Bonnie Brae will continue as underground storm drain facilities are installed and utility services are crossed under Bonnie Brae and tied-in to the new infrastructure. Message boards will be updated in advance of these planned closures. Follow posted detour signs.
The overall project is expected to be complete in November of 2026. Look for progress pictures and videos under the coordinating tab on the right.
We appreciate everyone's patience as we work hard to make these necessary improvements. Please remember to be considerate of work zones and road conditions, driving safely and according to the conditions.
-
Phase 6 - Full Notice to Proceed given to Tiseo Paving Company
Share Phase 6 - Full Notice to Proceed given to Tiseo Paving Company on Facebook Share Phase 6 - Full Notice to Proceed given to Tiseo Paving Company on Twitter Share Phase 6 - Full Notice to Proceed given to Tiseo Paving Company on Linkedin Email Phase 6 - Full Notice to Proceed given to Tiseo Paving Company linkOn March 10, 2025, the City of Denton issued a full Notice to Proceed to Tiseo Paving Company to be able to fully mobilize into the project limits. Tiseo will begin by concentrating on Riney Road from Bonnie Brae to Hardaway Road.
-
Partial Notice to Proceed issued to Tiseo Paving Company
Share Partial Notice to Proceed issued to Tiseo Paving Company on Facebook Share Partial Notice to Proceed issued to Tiseo Paving Company on Twitter Share Partial Notice to Proceed issued to Tiseo Paving Company on Linkedin Email Partial Notice to Proceed issued to Tiseo Paving Company linkCity Staff issued a Partial Notice to Proceed (NTP) to Tiseo Paving Company on February 10, 2025. The Partial NTP allows the Contractor to order material needed for the project which may have large lead time to get from factory to project site. The Partial NTP also allows for the Contractor to complete some work tasks agreed to between the City and the Contractor.
-
Construction Award to Tiseo Paving Company (Bonnie Brae Phase 6 - University Dr. to N. Elm St.)
Share Construction Award to Tiseo Paving Company (Bonnie Brae Phase 6 - University Dr. to N. Elm St.) on Facebook Share Construction Award to Tiseo Paving Company (Bonnie Brae Phase 6 - University Dr. to N. Elm St.) on Twitter Share Construction Award to Tiseo Paving Company (Bonnie Brae Phase 6 - University Dr. to N. Elm St.) on Linkedin Email Construction Award to Tiseo Paving Company (Bonnie Brae Phase 6 - University Dr. to N. Elm St.) linkOn December 17, 2024, the City Council award a contract to Tiseo Paving Company for the construction of the Bonnie Brae Phase 6 Improvement Project.
-
News Feed - January (Bonnie Brae Phase 5_ University - Scripture)
Share News Feed - January (Bonnie Brae Phase 5_ University - Scripture) on Facebook Share News Feed - January (Bonnie Brae Phase 5_ University - Scripture) on Twitter Share News Feed - January (Bonnie Brae Phase 5_ University - Scripture) on Linkedin Email News Feed - January (Bonnie Brae Phase 5_ University - Scripture) linkCity Council has voted this project to be reclassified to a Mill/Overlay project and for the funds to be disruptive to other Capital Projects.
Project Information
Estimated Budget: $140 million
Sponsoring Department:
Capital Projects
Streets Department
Water & Wastewater Utilities
Funding Sources: 2012, 2014, and 2019 Bond Programs, TRIP08 & TRIP22 County Bond Programs, NCTCOG RTR Funds
Project Location: Bonnie Brae Street from Vintage Blvd on the south end to US77/Elm Street on the North end. Once Complete, Bonnie Brae will be a 6 mile, north-south, 4 lane divided, urban connector with quick access to Loop 288, US380, I35E, FM1515, I35W and US377.
Who's Listening
-
Phone (940) 349-7113 Email Robin.Davis@cityofdenton.com -
Phone (940) 349-7715 Email Jesus.Perez@cityofdenton.com -
Phone (940) 349-8909 Email scott.fettig@cityofdenton.com
Stay Updated and Have Your Say
Click HERE to register to stay informed and ask the project manager a question about the Bonnie Brae Capital Improvement Project.
